Contractors sprint to upgrade Vic Falls–Byo road

Zimbabwe News Update

🇿🇼 Published: 09 December 2025
📘 Source: CITE

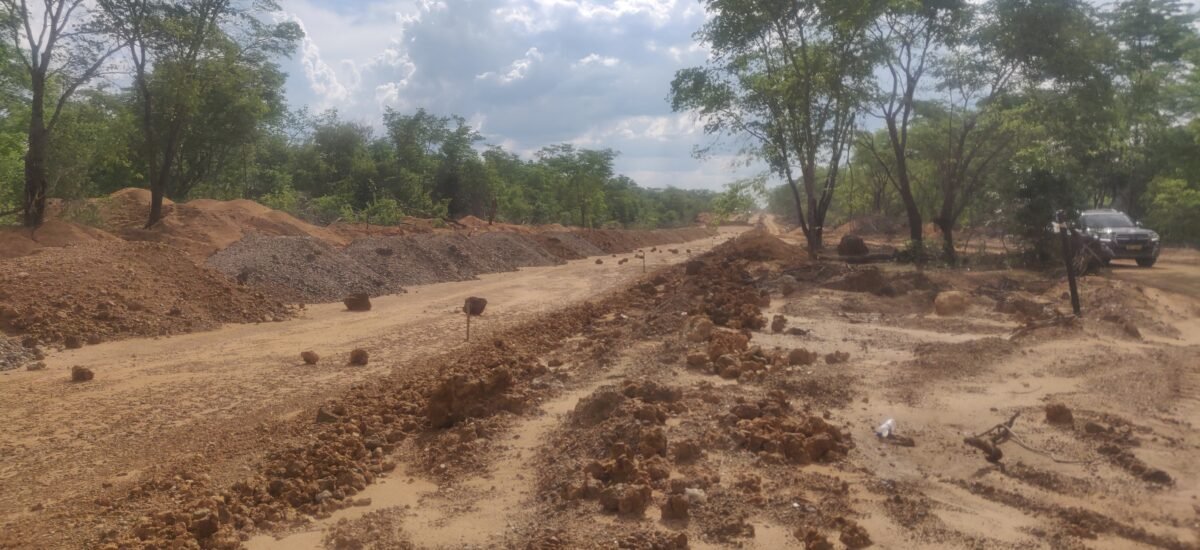

Eight contractors rehabilitating the Bulawayo–Victoria Falls Road say they are racing against time and the rains to deliver a safer, wider and more modern highway along one of Zimbabwe’s busiest tourism and freight corridors. Fossil Contracting, responsible for the first 51.4km from Bulawayo, said it has already opened 6.3km to traffic. Head of Operations Engineer Kudakwashe Maguta said the company’s chainage begins “at the Statue,” covering 48.6km plus an additional 2.8km near Airport Road.

“Of this first section which we have opened, 5km have been completed double seal,” he said. “The other 1.2km is having tailcoat… so the first 6.3km should be ready for opening any day.” He said another 8.8km had been opened for construction and should be ready by mid-February. “By mid-February we should be having a total of 15km opened to traffic,” he added.

He noted that Kalahari sands posed a major engineering challenge but said, “We have come up with innovative solutions… blending that Kalahari sand with the gravel that is locally available, and we are producing perfect results.” Masimba Construction, working on a 50km stretch, said its first priority was making the corridor drivable. Group CEO Fungai Matawa said, “Our first approach was dealing with potholes… there are actually ditches on the road.” He said the company wanted the “worst section” to be ridable by Christmas. Project Manager Engineer Blessing Nhau said 5km had been stabilised and was ready for priming.

📖 Continue Reading
This is a preview of the full article. To read the complete story, click the button below.

Read Full Article on CITE

AllZimNews aggregates content from various trusted sources to keep you informed.

[paywall]

“We had a number of accidents, breakdowns… so that was our first approach,” he said. The company aims to finish 10km before shutting down for the holidays but has been delayed by moisture beneath the surface. “Water then stays locked underneath… moisture doesn’t go out quickly,” Nhau said.

Syvern Investments, responsible for another 50km, said 5km is already open to traffic. Project Manager Arnold Mutungwazi said, “We started in June and to date we have finished 5km… We expect to finish the project by mid-August next year, all things being equal in terms of funding and resources.” He said an additional 9km was ready for cement stabilisation. Under a Public Private Partnership, Road Trackers is upgrading a massive 240km stretch from Lupane to Nkayi, Silobela and Kwekwe.

Project Manager Brighton Vundla said the works include both earth and tarred sections. “The road is 240km… we have two stages,” he said. “Base three is natural gravel… base two is natural gravel stabilised with three percent cement, then base one is G1.” He said 15km had reached subgrade level, and 10km of base work was complete. “On this project… we are putting tollgates and two weighbridges because we want to safeguard this infrastructure from these trucks,” he said.

[/paywall]
